Southampton Link Main

We're investing over £100 million to build a new 19km pipeline and pumping stations connecting our Otterbourne, Yew Hill and Rownhams sites. This will allow us to move water around our network to where it’s needed most, protecting water supplies and the environment during a drought.

background

Why we need the Southampton Link Main

 The South East is officially classed as water-stressed due to the need to leave more water in the environment, coupled with a growing population and changing climate. Hampshire relies heavily on the environment for drinking water, with most of it coming from underground and the rest from sensitive chalk stream rivers, like the River Test and River Itchen. New environmental limits mean we must reduce the amount of water we take from these rivers, especially during a drought.

We’re transforming the way we source, treat and supply water across Hampshire. Creating a new, resilient, and sustainable water supply will protect and enhance the county’s rare and sensitive chalk streams, while maintaining supplies for our communities and the local economy.

We’re investing millions in a range of solutions:

  • Developing new sources of water – including water recycling to keep treated water within our network.
  • Building a network of new pipelines to link up our key sites and allow additional transfers of water from neighbouring water companies.
  • Teaming up with Portsmouth Water to build a new reservoir at Havant Thicket to be used as a strategic water resource for the South East.

These are all part of our 'Water for Life – Hampshire’ programme, which addresses the county’s water shortfall.

About the project

We are building a network of new pipelines to link up our key sites and allow additional transfers of water from neighbouring water companies. The Southampton Link Main is one of these pipelines. Moving water around our network will help make it more resilient and means we can take less water from the River Test and River Itchen.

Once complete, the Southampton Link Main will improve resilience by reducing the impact of burst pipes, mechanical failures, or sudden increases in demand. So, if there was a problem at one of our sites, we can use one of the others to keep people supplied with drinking water.

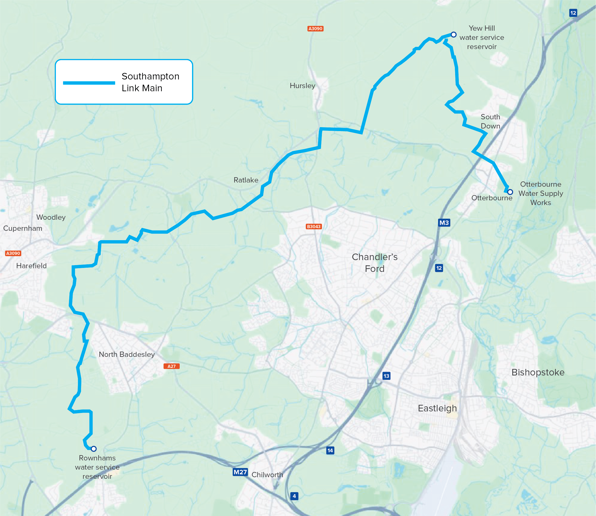

The pipeline will run underground between our Otterbourne Supply Works and the Yew Hill underground reservoir near Winchester. From Yew Hill, it will continue south to Rownhams, where another underground reservoir supports the wider water network. We are also increasing the capacity of Yew Hill Reservoir to support long-term demand and improve network resilience.

The route has been carefully selected using insights from landowners, residents and businesses, along with detailed environmental and ecological information, surveys and assessments.



Project timeline

Here's a timeline of what we've done so far and how we plan to complete the project.

1

Autumn 2025

The main excavation work for the new Yew Hill Reservoir begins.

2

Winter 2025/26

Construction work continues at Yew Hill, including pouring the concrete that forms the base and structure of the reservoir. During this time, work on three tunnelling sections begins, including under the M3 motorway and  between Shaft 2 and Oakwood Park Recreation Ground.

3

Spring 2026

 Two major sections of the new water pipelines are completed and thoroughly tested to make sure they are ready for use.

4

Winter 2026/27

Work continues on the pipelines, with both the northern and southern sections around the railway crossing completed. At the same time, the new Otterbourne High Lift Pumping Station will be built and fully tested.

5

Spring2027

Water will begin flowing through the new pipeline from Otterbourne to Yew Hill, once the relevant work at Otterbourne is completed. Additional testing will take place along the southern part of the pipeline to make sure it’s fully watertight.

6

Autumn 2027

We’ll carry out tunnelling under the railway. Testing will continue on the northern part of the pipeline. Later in the season, water will begin flowing through the new pipeline from Rownhams to Yew Hill.

7

Winter 2027/28

The project will finish, with the new water supply route from Otterbourne to Rownhams brought into service. We’ll also improve the Butterfly Sanctuary at Yew Hill Reservoir by planting a new chalk‑based habitat designed to encourage biodiversity.

Our work so far

Construction is well underway. We’ve built a 3.6km temporary access road from Poles Lane to Yew Hill to allow construction vehicles to reach the site with minimum impact to local residents.

Next, we’ll continue tunnelling, installing the pipeline and upgrading the reservoir through to 2027.

Most of the pipeline will be laid in open trenches before being backfilled. However, in some areas, it will be installed by digging tunnels deeper underground to avoid disruption to major roads, railway lines or precious ecological sites.

More information on upcoming work, including road or footpath impacts, will be added here as the project develops. We would like to thank you for your support and patience whilst we undertake this essential work.


Contact the team

We’re committed to working with you throughout the construction works in an open and collaborative way.

If our works causes you any concerns, we want to hear from you so we can put it right or improve the way we do things.

If you have further queries then please contact Laura Gale, MGjv Customer Liaison Officer on 07706 322744 or email SLMcomms@MGJV.co.uk

Alternatively call us out of hours on 0330 3030 368. Just tell us you’re calling about Capital Projects, with Project Reference Number (PRN) 710026, so we can help you more quickly. Or you can email us at capitalcomms@southernwater.co.uk

Frequently asked questions

Here are some of your questions which are often asked about this pipeline work.

We’ll be using a mixture of open-cut (trenching) and no-dig (tunnelling) to build this pipeline.

Our work won’t affect your water supply but you’re likely to notice general construction activity in the local area. Sections of the pipeline will run through more built-up areas, and we’ll make every effort to minimise disruption.

In January 2026, we’ll close the far-left corner of Oakwood Park Recreation Ground at the boundary with Otterbourne Water Supply Works. The football pitch and children’s play park will be open as usual.

Where work is in built up areas or near to a road you will see us. At night, we’ll use lighting to make sure we work safely. We’ll place barriers around noisy equipment, and we’ll monitor noise from the works to make sure we meet regulations.

You may notice an increase in traffic during the works. We have traffic management plans in place to minimise the impact on local communities.

There will be  car parking for the team on site, away from residential areas. There will be no impact to parking spaces in the local area.

Preparation work and pipelaying activities:

Monday to Friday, 7am to 6pm. They’ll be times when we need to work weekends, but we’ll keep this to a minimum.

Tunnelling:

Working hours during tunnelling will be Monday to Sunday, 7am to 6pm. Whilst we’re tunnelling beneath the railway track south of Crampmoor or other critical infrastructure, we may need to work 24 hours a day, 7 days a week.

Yew Hill Reservoir:

Monday to Friday, 7am to 6pm. There may be time where we’ll need to work weekends and overnight, but we’ll keep this to a minimum.

We’ll make sure everything is restored just as it was before we started, with the added benefit of the improvements to the Yew Hill Reservoir butterfly sanctuary.
